The short version
A pothole
- Who fixes it
- StreetsLA crews, with hot mix and a truck.
- Service level
- Three business days. 92% of 19,252 requests met it in FY2021.
- Who pays
- The City. The roadway is City property.
- Legal frame
- Routine maintenance.
- Our cases, Sep 2, 2026
- 40 filed, 80% resolved, median City closure five days.
A sidewalk
- Who fixes it
- Bureau of Engineering's Sidewalk Repair Program for the permanent repair. StreetsLA lays temporary asphalt.
- Service level
- None published. Asphalt patches took 41 days on average, 24 at the median, in FY2021.
- Who pays
- The fronting owner, after one City repair under fix and release. City spend capped at $20,000 per lot.
- Legal frame
- Willits v. City of Los Angeles, $1.37 billion over 30 years, plus Streets and Highways Code 5610.
- Our cases, Sep 2, 2026
- 5 filed, 0 resolved, all open past 18 days.
Who owns a sidewalk repair in Los Angeles?
Start with the law. California Streets and Highways Code section 5610 says the owner of a lot fronting a public street must maintain the sidewalk so it does not endanger people or property. Los Angeles wrote the same duty into its municipal code, section 62.104, and added the words "or violate the Americans with Disabilities Act." A pothole sits in a roadway the City owns and maintains outright. The sidewalk in front of your house is yours to maintain and the City's to answer for: the Controller counted more than 1,700 claims and 1,020 lawsuits for sidewalk injuries over five fiscal years, with more than $35 million paid.
The owner holds the duty. The City carries most of the liability. That split is the first reason nothing about a sidewalk is simple.
Then the settlement. In 2010, disability rights advocates and three residents with mobility disabilities sued the City over sidewalks and curb ramps that wheelchair users could not use. Willits v. City of Los Angeles was settled and finalized in 2016: the City committed at least $1.37 billion over 30 years to fix sidewalks, curb ramps, and other barriers in the pedestrian right of way, the largest disability access settlement in the country at the time, for an estimated class of 280,000 Angelenos with mobility disabilities. The Sidewalk Repair Program launched in December 2016. With it came the fix and release policy: the City makes the first repair, issues a Certificate of Sidewalk Compliance, guarantees one warranty repair for 20 years on residential property or 5 years on commercial and industrial property, caps its own spend at $20,000 per lot (inflation adjusted), and after that can enforce the owner's duty to maintain.
StreetsLA sits alongside this program, not inside it. It lays temporary asphalt over the worst uplifts and, per the Controller, has no program with resources dedicated to routine sidewalk maintenance.

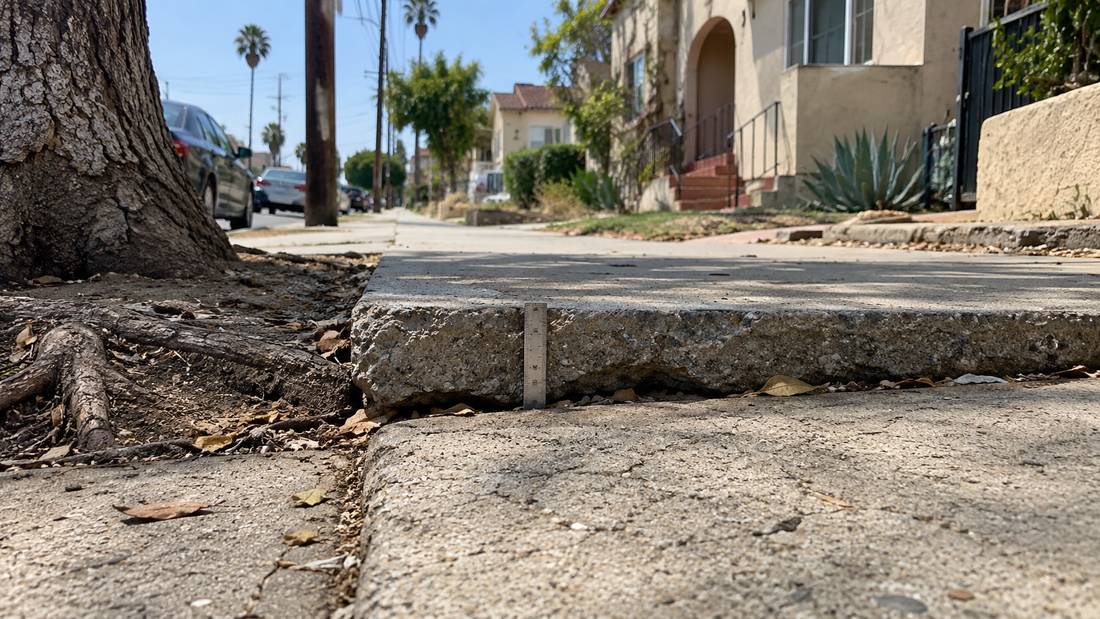

The quarter inch that changes everything
This is where the ADA enters the timeline. A pothole is fixed when the hole is filled. A sidewalk repair that counts toward the settlement has to meet federal accessibility standards, and the City publishes the list it inspects against: an uplift greater than a quarter inch, a sidewalk narrower than four feet, a cross slope steeper than 2 percent, a gap or grate opening wider than half an inch, and root heave that breaks the running grade. Those numbers come from the 2010 ADA Standards and the federal guidelines for public rights of way. A crew with hot mix cannot meet them. Concrete comes out and goes back in under permit, to the City's standard plan, often after an arborist decides what happens to the tree that lifted it. City policy replaces every street tree it removes with two.
And the City goes further than the standard requires. The Controller's 2021 audit found that neither the ADA nor the settlement requires the City to rebuild the entire sidewalk on a parcel when only small defects exist in a few spots. The Ninth Circuit put sidewalks under the ADA in Barden v. Sacramento in 2002, and in that same case the Justice Department told the courts that the ADA's "program access" standard for existing sidewalks does not require a city to replace them wholesale. The fix and release policy assesses the whole parcel anyway, so each certificate becomes a small construction project. The audit recommended focusing on significant defects instead, the way New York, Sacramento, Portland, and Seattle do. That is not neglect. It is a policy choice that trades speed for completeness, made by a city trying to end a decade of litigation.
One example from the audit shows where the time goes. A City owned corner parking lot took 460 days from assessment to finished sidewalk. Design took about 30 days and construction about 65. The rest was property access agreements, public contracting, and street trees.
Why is the queue so long?
Scale. Los Angeles has more than 9,000 miles of sidewalk, about 11 square miles of concrete, across roughly 640,000 parcels. By mid 2021 the City had completed repairs at about 2,100 sites and issued 4,879 certificates of compliance, less than one percent of parcels. NBC4's I-Team did the arithmetic on the audit: at that pace, nearly 500 years. Separately, more than 50,000 sidewalk problem reports over six years sat outside the settlement work entirely, because ordinary maintenance is not what the program funds. As of the settlement's tenth anniversary in August 2026, the City reports more than $370 million spent and a backlog of more than 4,400 requests.

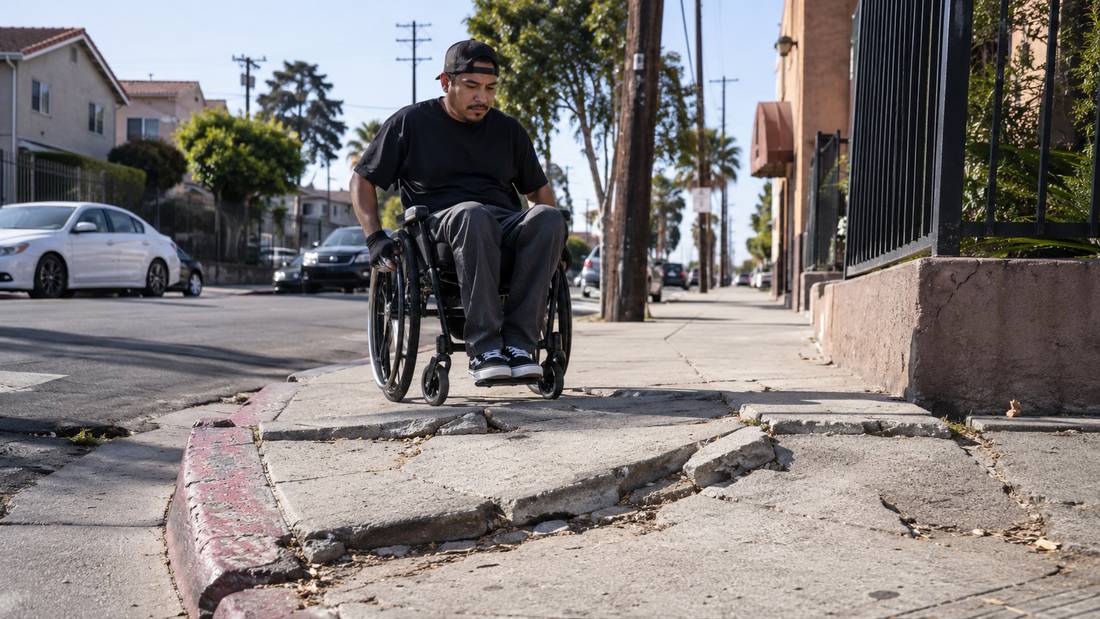

Priority. The program exists to satisfy an accessibility settlement, so it starts where the law starts: with people who cannot use the sidewalk at all. The City's stated first priority is Access Requests, filed by or for a person with a mobility disability. Within those, the top of the list is residential locations within 500 feet of transit that have been waiting more than 120 days. Then come the roughly 2,700 City facilities the department has identified. An ordinary uplift on an ordinary block, reported by someone who can step over it, is at the back.
Money. Funding is set each year by the City Council, and the bureau that does the temporary patching lost $61 million, 26 percent of its operating budget, between FY2024 and FY2026. The owner rebate program is waitlisted: applicants go on the list when every available dollar has been reserved. By June 2021 the City had issued 538 rebate checks against 4,451 applications.
What happens when you report a sidewalk through 311?
Your request lands in the City's 311 system like any other, then splits. For an immediate hazard, StreetsLA may lay a temporary asphalt patch; in FY2021 those took 41 days on average and 24 at the median. The permanent repair is logged with the Sidewalk Repair Program, which tells residents plainly that requests far exceed available resources and repairs may not happen right away. There is no published service level for completing an ordinary sidewalk repair, which is itself the answer to the question in the title.
We know because we went through that door. Sidewalk became a reportable issue type in CLARK AI by Tea For Streets in August 2026. In the second half of that month we filed five sidewalk reports through official 311 channels, each one checked by a person and filed the same way as our potholes. Each was accepted. Each came back with the same seven words: "received and filed for future reference." That is an honest description of a place in a backlog. It is not a work order.
Report it anyway. A filed request records what the City knew and when, which matters under California Government Code section 835, the statute that makes a public entity liable for a dangerous condition it had notice of and did not fix. If a member of your household has a mobility disability, file an Access Request instead of a general report; it is the only lane with a stated priority. And file with a measurement, not just a photo. A quarter inch is the legal line, and a photo cannot show it. Note the height of the lip in the description so the report carries a number.
